Infrastructure Delivery
Fibre networks and civil works across some of Oman's hardest terrain, delivered by our own crews and equipment from survey to handover.

FTTH and telecom fibre rollout

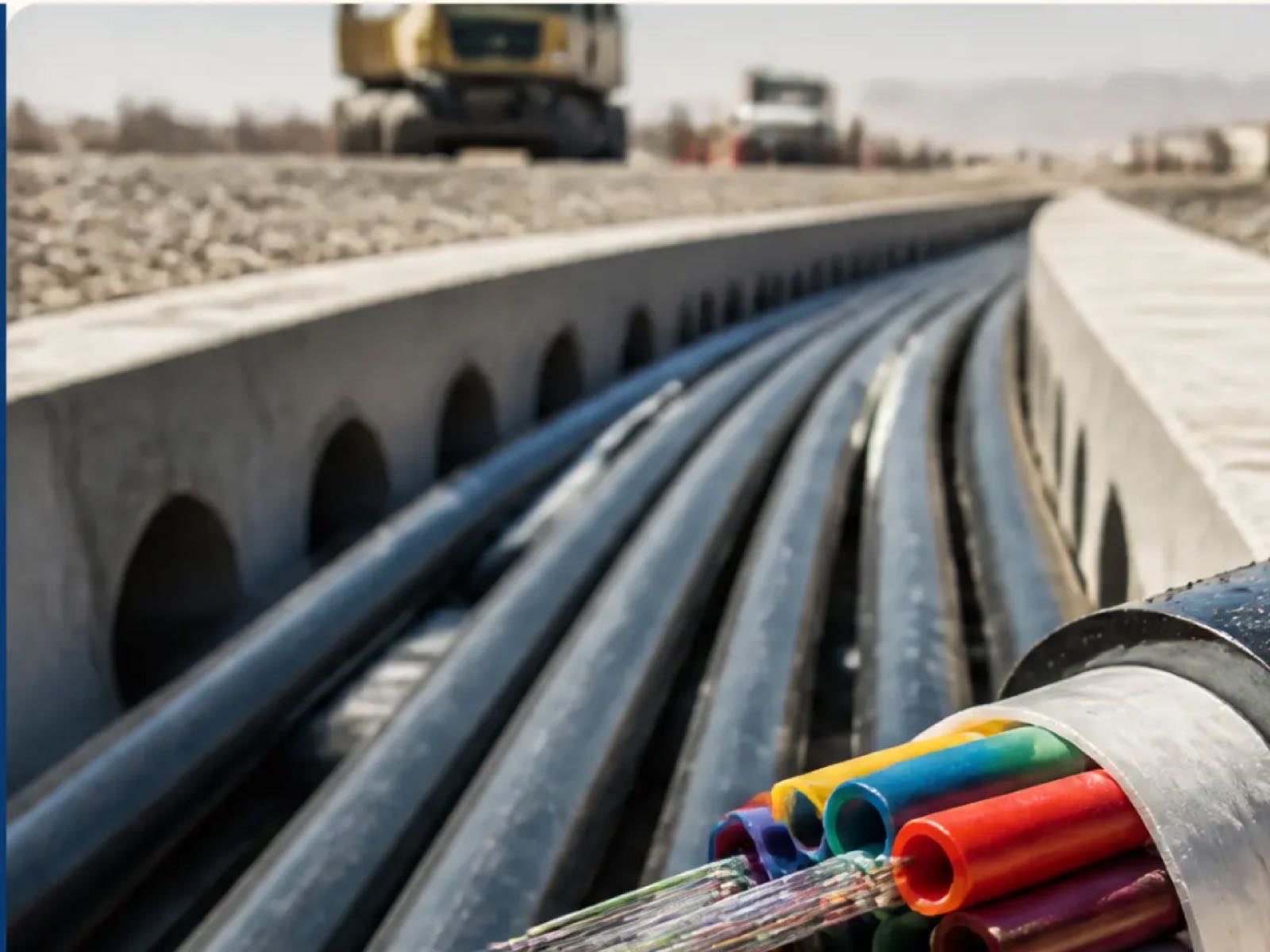

End-to-end fibre networks: trenching, ducting, chambers and cabinets, then fibre pulling, splicing and testing through to handover.
- Route survey and trenching
- Duct, chamber and FDH cabinet installation
- Fibre splicing and ODF testing
- Tower-to-tower fibre links

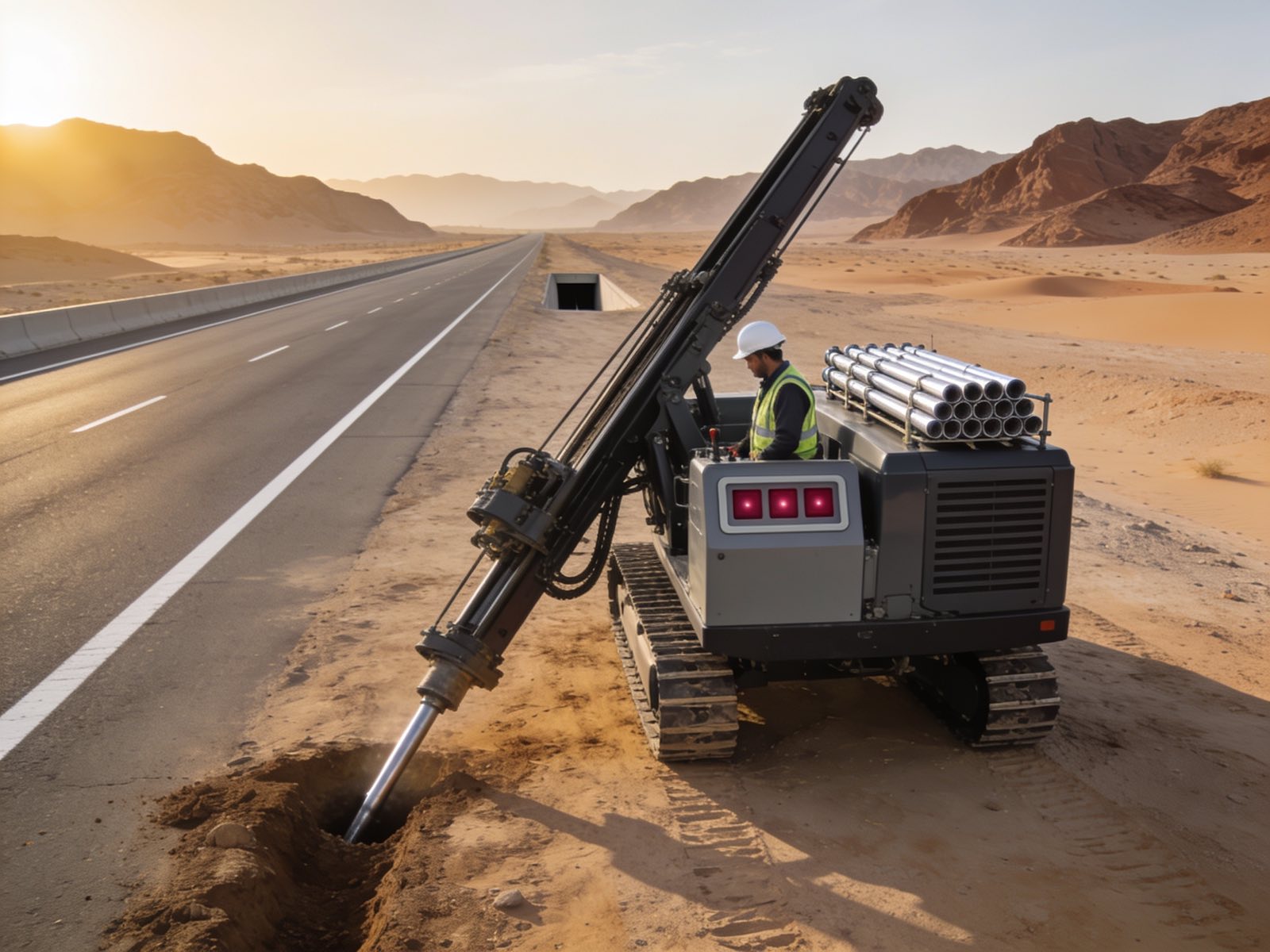

Horizontal directional drilling
Crossings under roads, pipelines and other obstacles without open cuts, protecting existing infrastructure and keeping traffic moving.
- Road and highway crossings
- Pipeline and utility crossings
- Minimal surface disruption
- Drilling in hard and mixed ground

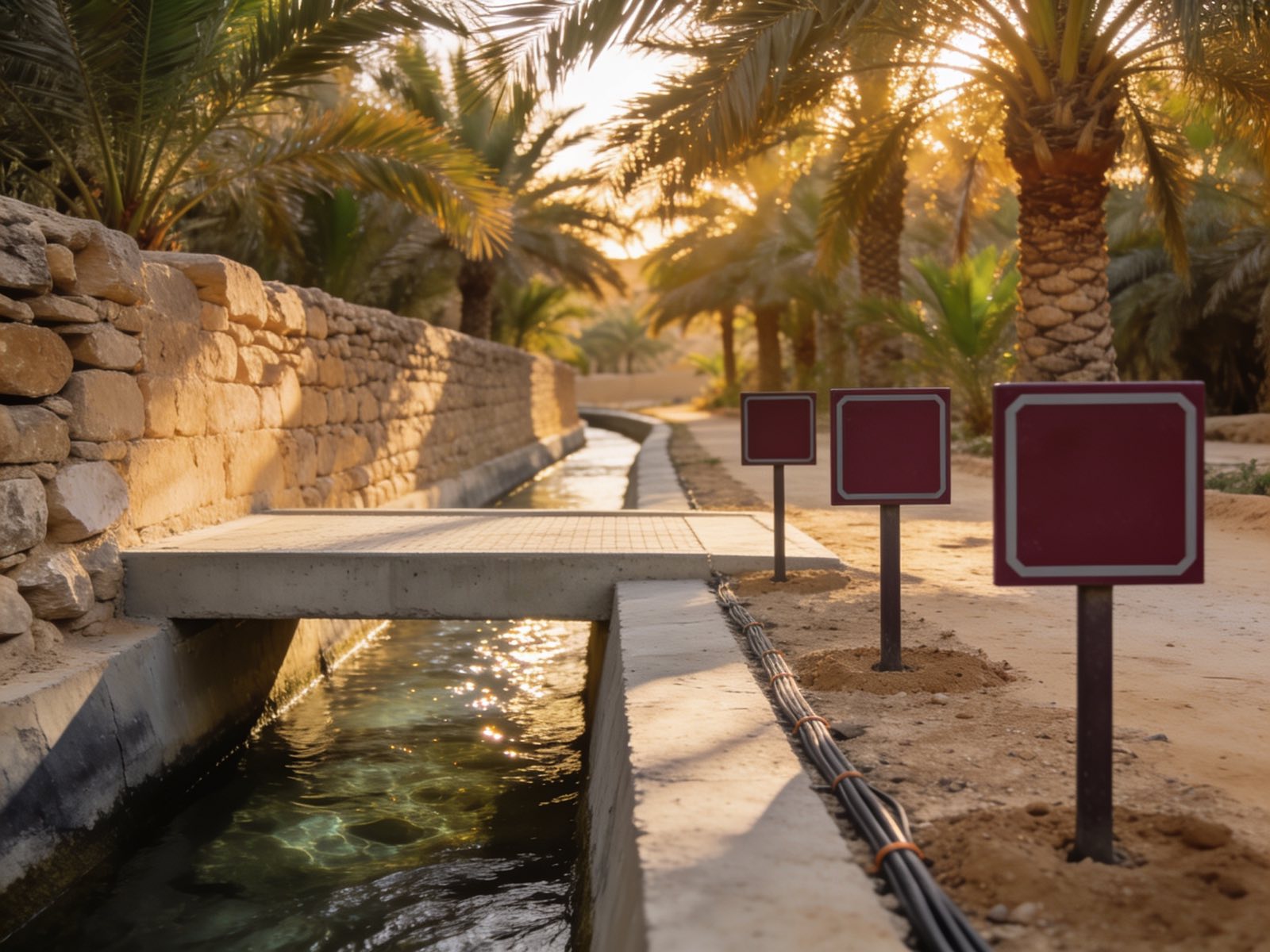

Wadi and falaj crossings
Secure crossings that hold up through seasonal flows, built with care for the land and the falaj systems communities depend on.
- Crossings designed for heavy flows
- Falaj and pipeline crossings
- Minimal environmental impact
- Grade 1 reinstatement

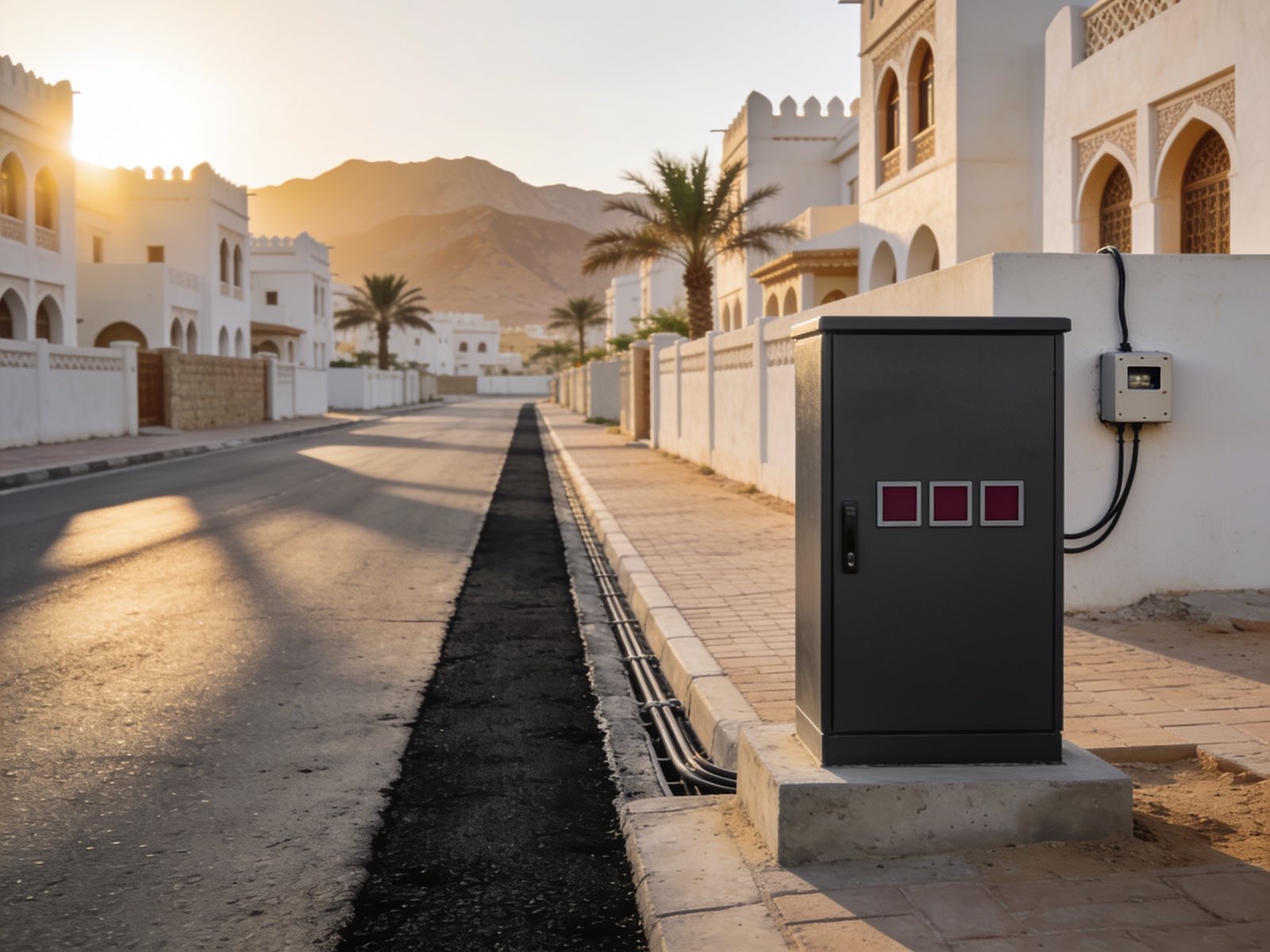

Civil works and logistics
Heavy-duty civil support with our own fleet: rock breaking, material transport and road reinstatement on large, multi-site projects.
- Controlled rock breaking and excavation
- Material and blasted-rock transport
- Asphalt cutting and reinstatement
- Heavy-equipment fleet and site logistics
Delivered so far
From survey to handover
Every phase is run to written technical standards and a fixed timeline.
Plan
Site surveys, route design and resource mapping.
Mobilise
Crews and heavy equipment deployed quickly, across several sites at once if needed.
Install
Civil works and network assets built to specification.
Test and hand over
Splice and ODF testing, as-built records and a clean site.
Project record, 2022 to 2025
A selection of fibre programmes delivered across the Sultanate.
IbraFTTH rollout
102.7kmNew trenching and ducting across rocky terrain. 206 FDH cabinets installed and 4,078 chambers built.
Sur NorthFTTH rollout
86.8km60% hard-rock terrain with 36 heavy-equipment units. 920 m of HDD and 950 m of wadi crossings.
Bahla and Al MurFTTH rollout
86.7kmMixed terrain. 580 m of HDD, 2,150 m of wadi crossings and 880 m of asphalt reinstatement.
Al JadeedhFTTH rollout
76.8km110 mm ducting network with 21 FDH cabinets, 537 chambers and 800 m of asphalt reinstatement.
Tower-to-tower linkTelecom fibre
80kmFibre deployment and tower-to-tower connectivity.
MirbatTelecom fibre
32kmFibre installation with full ODF testing and verification.





Testing, quality and safety
- Splice validationEvery splice is tested to confirm network integrity and performance.
- Field auditsContinuous quality checks and monitoring on every active site.
- Safety protocolsInternational safety standards for a secure, controlled work environment.
